Board approves summer 2025 maintenance projects; district details sports-complex challenges

Get AI-powered insights, summaries, and transcripts

Subscribe
AI-Generated Content: All content on this page was generated by AI to highlight key points from the meeting. For complete details and context, we recommend watching the full video. so we can fix them.

Summary

The board approved a $742,000 summer maintenance package to address building repairs, gym floor refinishing, canopy bids, site concrete, and security camera work; administrators described the sports complex grading, ADA and utility constraints and reported new water-line leaks at the complex requiring repair.

The Richland County Community School District 1 Board of Education approved the district’s summer 2025 maintenance-project list and budget during its regular meeting.

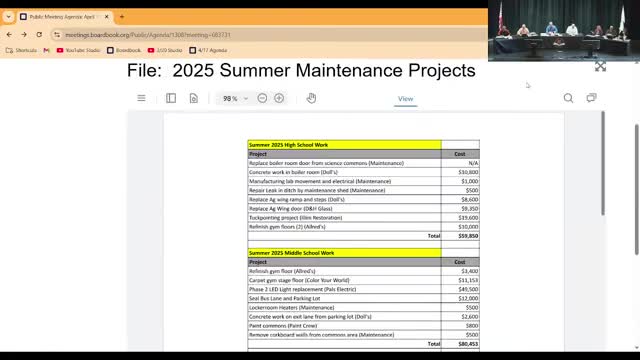

The projects — presented by district administration and approved by roll call — totalled about $742,000 in the presenter’s estimate and will be funded primarily from Fund 20 across two fiscal years, the administration said. The list covers a range of work across district buildings including replacement doors, boiler-room concrete, manufacturing-lab electrical upgrades, tuckpointing, gym-floor refinishing, lighting replacement (phase two), bus-lane sealing, canopy procurement for an elementary pickup area, playground demo and installation, and security camera installation at the bus garage and alternative-education building.

In the presentation, administrators also reviewed the sports complex site tours held for the community and engineers’ findings. The administration reported a 12-foot elevation difference across the field that drives water-flow and drainage problems; presenters said partial fixes to isolated areas would not resolve systemic grading and ADA issues. Staff described a million-dollar-plus estimate to replace the main grandstand and costs to rework restroom plumbing: the bathrooms currently have six stalls served by a 1.5-inch water line and a 4-inch sewer line, but code would require far more stalls for the facility’s seating capacity and a much larger water supply if a partial remodel were attempted, leading administrators to recommend comprehensive site work instead of piecemeal repairs.

Board members asked for clarifications about expansion joints and tuckpointing progress; administration said expansion-joint work is about two-thirds complete and some brick areas still need tuckpointing. For the middle and high school gyms, administration said the high-school gym floor is near the end of its usable life and will require replacement bids (estimated at $250,000–$300,000) next summer.

During the meeting’s later segments, administrators reported an emergent issue at the sports complex: the district’s water usage spike revealed three leaks in the 1.5-inch line that serves the concessions and restroom area. The district turned off that line; staff said repairing the remaining two-thirds of the run may require directional boring or excavation and estimated a likely cost near $20,000. The line currently prevents use of the bathroom building; porta-potties are in place for events while repairs are scheduled.

Board members approved the summer maintenance work on a motion by Mister Henderson, seconded by Mister Wilson. The roll call vote was recorded as yes by Mister Anderson, Mister Leist, Mister Snyder, Mister Henderson, Mister Wilson and Missus Bailey.
